Solar PV Startup & Energy Meter Recording Guide

Solar PV Startup & Energy Meter Recording Guide



The commissioning phase of a solar photovoltaic (PV) system marks the transition from installation to operational status. One of the most critical activities during this stage is initiating startup procedures according to manufacturer instructions and accurately recording energy meter readings at startup. This process verifies that all components are functioning correctly, ensures safe energization of the system, establishes baseline performance data, and confirms readiness for regular operation.



Whether it is a residential rooftop solar installation, a commercial solar project, an industrial renewable energy system, or a utility-scale solar power plant, proper startup procedures are essential for protecting equipment, ensuring personnel safety, and maximizing long-term system performance. Incorrect startup sequences can lead to equipment damage, inverter faults, electrical hazards, inaccurate monitoring data, and reduced system reliability.



Energy meter readings recorded during startup serve as the initial reference point for future energy generation analysis, performance ratio calculations, maintenance planning, warranty verification, and operational reporting. These baseline readings are crucial for evaluating solar electricity generation throughout the project lifecycle.



Systematic startup procedures and proper documentation are essential components of solar PV commissioning and renewable energy technology implementation.



This comprehensive guide explains startup preparation, commissioning requirements, startup sequences, meter verification procedures, documentation methods, safety precautions, and industry best practices.



Importance of Proper Startup Procedures



Startup is the first controlled energization of a completed solar PV installation.



Proper startup procedures help:



  • Protect equipment
  • Ensure system safety
  • Verify installation quality
  • Confirm design compliance
  • Establish baseline operational data
  • Support successful commissioning



Following approved startup procedures reduces the risk of operational problems.



Why Manufacturer Instructions Must Be Followed



Each solar PV component is designed with specific startup requirements.



Manufacturers provide procedures for:



  • Inverters
  • Battery systems
  • Charge controllers
  • Monitoring equipment
  • Protection devices



Failure to follow manufacturer instructions may result in:



  • Warranty issues
  • Equipment malfunction
  • Reduced efficiency
  • Safety risks



Therefore, startup activities should always align with manufacturer documentation.



Components Involved During Startup



Several key components are energized during startup.



1. Solar PV Array



The primary energy-generating source.



2. DC Combiner Box



Combines multiple string outputs.



3. DC Disconnects



Provide isolation for maintenance and emergencies.



4. Solar Inverter



Converts DC power into usable AC electricity.



5. AC Distribution Equipment



Distributes generated power.



6. Utility Interconnection Equipment



Required for grid-connected systems.



7. Battery Energy Storage Systems



Applicable in hybrid and off-grid installations.



8. Monitoring Systems



Track operational and performance data.



Pre-Startup Inspection Requirements



Before initiating startup procedures, several inspections must be completed.


  • Verify Installation Completion



Confirm that:



  • All equipment is installed
  • Construction activities are complete
  • Required inspections have been completed


  • Verify Mechanical Integrity



Inspect:



  • Mounting structures
  • Fasteners
  • Enclosures
  • Equipment supports



All components should be securely installed.


  • Verify Electrical Installation



Inspect:



  • Cable terminations
  • Conduit systems
  • Grounding connections
  • Protection devices



All wiring should comply with design drawings.


  • Confirm Testing Completion



Verify successful completion of:



  • Continuity testing
  • Insulation resistance testing
  • Grounding verification
  • Polarity testing



The startup should not proceed if testing is incomplete.


  • Verify Labeling



Ensure all equipment and circuits are properly identified. Proper labeling supports safe operation and maintenance.



Tools Required During Startup



Common tools and instruments include:



  • Digital multimeter
  • Clamp meter
  • Insulation tester
  • Commissioning checklist
  • Manufacturer manuals
  • Personal protective equipment (PPE)
  • Startup documentation forms

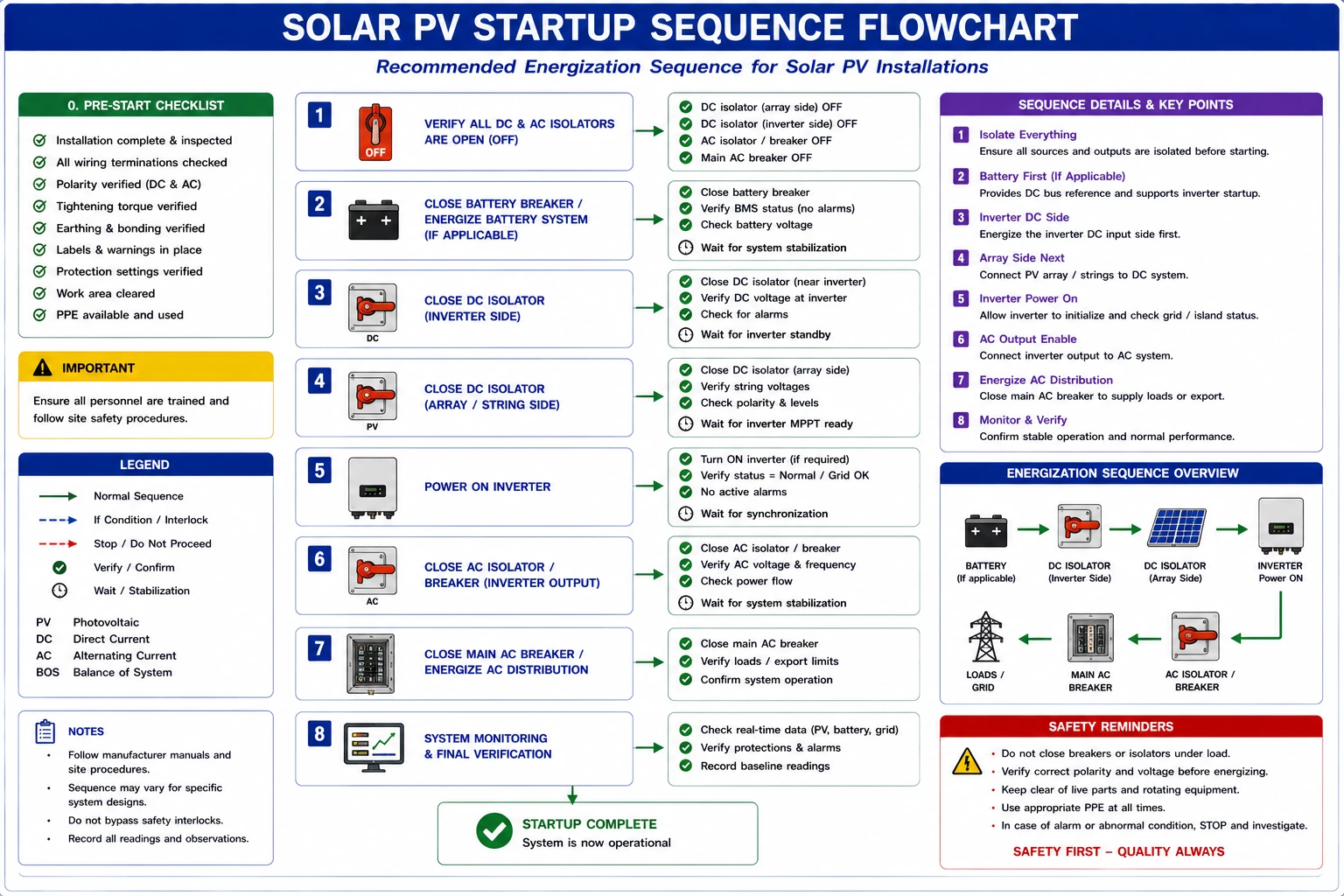

Initiate Startup Procedures as per Manufacturer Instructions and Record Energy Meter Reading at Startup- Complete Guide for Solar PV System Commissioning
Initiate Startup Procedures as per Manufacturer Instructions and Record Energy Meter Reading at Startup- Complete Guide for Solar PV System Commissioning



Step-by-Step Solar PV Startup Procedure



Step 1 – Review Manufacturer Documentation



Before energization:



Review:



  • Startup instructions
  • Safety warnings
  • Equipment manuals
  • Commissioning requirements



Ensure personnel understand the procedure.



Step 2 – Verify Safety Conditions



Confirm:



  • Work areas are clear
  • Personnel are informed
  • Required PPE is being used
  • Lockout/tagout procedures have been removed appropriately



Safety must remain the highest priority.



Step 3 – Inspect DC Side Components



Verify:



  • Solar strings are connected correctly
  • DC combiner boxes are secure
  • Disconnect switches are properly configured



Ensure no visible defects exist.



Step 4 – Verify Battery System Status



For battery-based systems:



Check:



  • Battery voltage
  • Battery polarity
  • Battery condition
  • Battery protection settings



Battery systems should be ready before inverter startup.



Step 5 – Energize DC Circuits



Close DC disconnects according to manufacturer procedures.



Verify:



  • Correct voltage levels
  • Stable operation
  • No abnormal conditions



Monitor system responses carefully.



Step 6 – Start the Inverter



Initiate inverter startup according to manufacturer instructions.



Verify:



  • Startup sequence completion
  • Status indicators
  • Display information
  • Fault-free operation



Most modern inverters perform automatic self-checks during startup.



Step 7 – Energize AC Side Equipment



After successful inverter startup:



Activate:



  • AC disconnects
  • Distribution equipment
  • Utility interconnection devices



Follow the prescribed sequence carefully.



Step 8 – Verify System Synchronization



For grid-connected systems:



Confirm:



  • Voltage synchronization
  • Frequency synchronization
  • Successful grid connection



Verify inverter operational status.



Step 9 – Check Monitoring Systems



Confirm operation of:



  • Data acquisition systems
  • Monitoring software
  • Communication systems
  • Remote monitoring platforms



Monitoring systems should begin recording operational data.



Step 10 – Observe Initial System Operation



Monitor:



  • DC voltage
  • DC current
  • AC voltage
  • AC current
  • Power output



Ensure values remain within expected ranges.



Importance of Recording Energy Meter Readings at Startup



Energy meter readings provide baseline operational data.



Startup readings establish:



  • Initial energy production value
  • Commissioning reference point
  • Warranty documentation
  • Performance monitoring baseline



These records are important throughout the system lifecycle.



Types of Energy Meters Used in Solar PV Systems



Generation Meter



  • Measures total solar energy produced.



Import/Export Meter



  • Measures energy exchanged with the utility grid.



Net Meter



  • Records imported and exported electricity.



Revenue Meter



  • Used for billing and energy accounting.



Parameters Commonly Recorded During Startup



Startup records often include:



Parameter

Description

DC Voltage

Array Operating Voltage

DC Current

Array Operating Current

AC Voltage

Inverter Output Voltage

AC Current

Inverter Output Current

Frequency

Frid Frequency

Energy Meter Reading

Baseline Energy Value

Inverter Status

Operational Condition

Startup Date & Time

Commissioning reference



Conclusion



Initiating startup procedures according to manufacturer instructions and accurately recording energy meter readings at startup are critical steps in the successful commissioning of solar PV systems. These activities verify installation quality, ensure safe energization, establish baseline performance data, support regulatory compliance, and contribute to long-term renewable solar system reliability.



Proper commissioning procedures are essential for achieving efficient solar electricity generation and maintaining renewable energy technology performance. Furthermore, adhering to technical recommendations and quality standards promoted by the Ministry of New and Renewable Energy helps ensure safe, compliant, and professional solar PV installations.



By following approved startup sequences, verifying equipment readiness, documenting energy meter readings accurately, monitoring system performance, maintaining comprehensive commissioning records, and addressing operational issues promptly, solar installers, EPC contractors, commissioning engineers, and project managers can optimize solar panel system cost, improve renewable solar system reliability, maximize operational efficiency, and ensure the long-term success of residential, commercial, industrial, and utility-scale solar energy projects.



FAQs



Q1. Why are manufacturer startup procedures important in solar PV systems?

Ans: Manufacturer procedures ensure safe equipment energization, protect system components, maintain warranty compliance, and verify proper operation.



Q2. What should be checked before starting a solar PV system?

Ans: Installers should verify mechanical installation, electrical connections, grounding systems, testing completion, equipment labeling, and safety conditions.



Q3. Why is the energy meter reading recorded at startup?

Ans: Startup meter readings establish a baseline reference for future energy production monitoring, warranty verification, maintenance planning, and performance analysis.



Q4. What types of meters are commonly used in solar PV systems?

Ans: Common meter types include generation meters, net meters, import/export meters, and revenue meters.



Q5. What should be done if an inverter displays a fault during startup?

Ans: The startup process should be paused, the fault investigated according to manufacturer guidelines, corrective actions implemented, and the system retested before proceeding.

Suggested Articles

500 kW Solar Power Plant Cost in Rajasthan

Minimum Land Requirement for Solar Power Plants in India

Understanding the land requirement for solar plant projects in India is essential for accurate planning and approvals. This article explains minimum land needed per kW and MW, key influencing factors, and differences between rooftop and ground-mounted solar plants.

Solar Shingle

Should You Replace Solar Panels with Solar Shingles?

Discover how solar batteries store excess energy, maximize your solar system’s efficiency, and provide reliable power during outages. Learn about the types, benefits, lifespan, and maintenance tips to make the most of your solar investment.

pic_cetp

Solar Rooftop Subsidy: Why It’s Time for a Change of Mindset

While solar rooftop subsidies help reduce upfront costs, true adoption requires a mindset shift. This guide discusses why businesses and homeowners should focus on long-term benefits, sustainability, and strategic planning beyond relying solely on incentives.

Contact Us
